Moss Vale Station and Stabling Yard Upgrade

Community Update: Come and celebrate the completion of the major safety and accessibility upgrades at Moss Vale Station.
Transport for NSW Invites the Moss Vale community join in the celebrations to mark the completion of major safety and accessibility upgrades at Moss Vale Station (PDF, 136.18 KB), as part of the NSW Government’s commitment to strengthening regional communities.
When: Saturday, 26 July
Time: 11.00 am - 1.00 pm
Where: Moss Vale Station Forecourt
It's going to be a wonderful event with a community BBQ, CWA serving treats and a coffee van as well as the Picnic Steam train arriving to the station during the event.
About the Upgrade Works
The NSW State Government is nearing completion of upgrading the Moss Vale Station and Stabling Yard. The project aims to achieve Disability Standards for Accessible Public Transport 2002 (DSAPT) compliance and to accommodate the new Regional Rail Fleet.
The upgrades were to improve accessibility to those with a disability, limited mobility, parents/carers with prams and passengers with luggage, while ensuring the station precinct aligns with Moss Vale’s transport needs.
Public input was sought during the design process, which was crucial in determining the best possible design outcome for the community. As a result, a “Kiss and Ride” zone and the inclusion of a noise barrier on Lackey Road were incorporated into the design.
The main areas for improvement include:
- Station access from both the eastern and western sides of the station
- Parking layout
- Station Building, amenities and platforms
- Stabling Yard to accommodate the new Regional Rail fleet
July Works 2025
What works will be happening in July:
● work on the pedestrian footpath and lift entrance on Lackey Road.
● landscape in front of the new noise wall
● repave and set up new parking, signage and directional line marking on Dalys Way and at the station entrance.
● continue to work on the high voltage power upgrade and train refuelling bay
● install additional track.
What will this mean for the community:
● Lackey Road will continue to have intermittent traffic control, including some temporary lane closures, to enable the delivery of new track for the upgraded stabling yard.
● The Lackey Road footbridge and lift will reopen from mid-July (weather permitting). The current shuttle bus service between arret Street and Argyle Street will remain in place until the footbridge reopens.
Head here for the project page with more info and contact details.
Transport for NSW | Moss Vale Station and Stabling Yard
June 2025 Works
During this period we will be:
- continuing the upgrade of the pedestrian footpath and road works on Dalys Way
- continuing drainage on Dalys Way and around the Argyle Street lifts
- continuing noise wall installation and anti-graffiti treatment application
- upgrading the footpath and pedestrian crossing on Lackey Road
- cleaning the existing heritage wall on Lackey Road
- upgrading the stabling yard power and security systems
- carrying out train refuelling bay upgrades
- performing minor work to the platform buildings
- continuing planting and landscaping on Lackey Road, station courtyard, Dalys Way and around the Argyle Street lifts.
What this means for the community:
- there will be no vehicle or pedestrian access along Dalys Way, and no pedestrian access via the Lackey Road footbridge
- pedestrian access along Dalys Way will be reinstated in early June, weather permitting
- the station is accessible via Argyle Street footbridge and lifts
- Lackey Road will have intermittent traffic control with some temporary lane closures
- all buses will arrive and depart on Argyle Street near Leighton Gardens
- the commuter car park next to Diamond Jubilee Park will reopen in early June
- the station master's office work is complete with access via Platform 1
- the shuttle bus service will remain active while the Lackey Road footbridge remains closed
What times will works be taking place:
Most work will take place during standard construction hours of 7am to 6pm Monday to Saturday.
Transport for NSW will be working at the station between 6am and 6pm on Saturday 7 June. For the safety of staff and passengers, this work will take place during a scheduled Sydney Trains trackwork period when no trains are running, and the station is closed.
Head here for the project page with more info and contact details.
Transport for NSW | Moss Vale Station and Stabling Yard
May 2025 - Noise Wall Installation

To help reduce noise from Moss Vale Station and Stabling Yard a noise wall approximately 250 metres long is being installed on Lackey Road along the western side of the stabling yard.
Find out more here(PDF, 1MB)
For more information contact Transport for NSW via email or 1800 684 490.
April/May 2025 Works

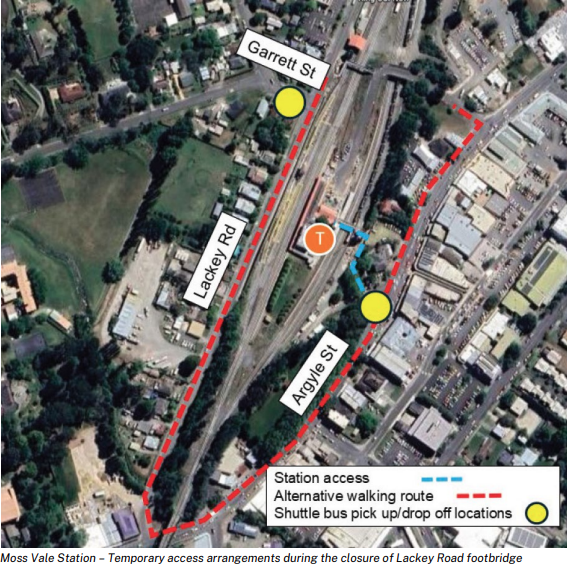

From Tuesday 29 April, the Lackey Road footbridge at Moss Vale Station will be closed for about two months to facilitate accessibility upgrades to the area.
This will require the local community to follow the alternative route shown in the attached notification to travel between Lackey Road and Argyle Street. This detour covers a distance of approximately 1.1km and takes around 14 minutes on foot.
To mitigate impacts to the local community during this time, a free shuttle bus service will run between Lackey Road/Garrett Street and Argyle Street (near Leighton Gardens) every 15 minutes. This service will be in place Mondays to Fridays between 6am and 9am & 3pm and 6pm.
To ensure passengers and community members were provided with sufficient notice, the following measures have been carried out:
- Installation of corflute signage at Moss Vale Station and on the Lackey Road footbridge (attached)
- Installation of VMS signage at high foot traffic areas on Argyle Street and Lackey Road
- Details included in the April community notification, followed by a further community notification with details of shuttle bus arrangements (attached)
- Installation of bus stop signage on Argyle Street and Lackey Road (attached)
- Installation of wayfinding signage at the footbridge and Moss Vale Station to further assist customers (attached)
Please note – we also have an arrangement in place with Southern Highlands Taxis for outside of shuttle bus hours. In the event customers call our 24-hour hotline to make a complaint or enquire about alternative arrangements, out hotline staff will direct them to call Southern Highlands Taxis directly to make a booking.
This service would only follow the shuttle bus route and invoiced to Transport for NSW.
For more information visit www.transport.nsw.gov.au/mossvale
March 2025 Works
In March the works will include
Construction is now under way on site in stage 2 of 4 stage construction. The project is expected to be completed by late 2025.
Works will include:
- Argyle Street: two new lifts, at each end of the existing footbridge
- upgrade to footbridge and walkway
- accessibility upgrade to bus stop and taxi drop-off Jubilee Park
- upgrade to Argyle St entrance including seating and signage and improved access to pedestrian pathway
- Lackey Road: a new lift to existing footbridge
- upgrade existing footbridge and stairs (new handrails/decking)
- footpath upgrade and installation of new seating at new lift entrance near Lackey Rd.
- installing pedestrian crossing at Lackey Rd and Dalys Way
- upgrade to footpath accessibility at Dalys Way towards the station, including fencing, drainage, car park and retaining wall.
Parking
- provision of accessible parking spaces
- new kiss and ride zone (additional kiss and ride zone will be included on Argyle St near Jubilee Park.)
- bus/coach drop off
- Commuter car park: 6 spaces converted to electric charging bays
Station, amenities and platform
- adjusting some station doors
- correcting ground levels
- resurfacing Platform 2
- replacing unisex toilet with family accessible bathroom
- install tactile markers and boarding assistance zones on both platforms
- improving communication equipment, PA system and security systems
- upgrades to station power services, communications room, lighting and CCTV.
- line marking, landscaping and adjusting station ticket facilities
Stabling Yard
- Upgrades to accommodate new Regional Rail fleet
- lengthening track at stabling yard
- installing dedicated access driveway for ARTC
- upgrade to existing Lackey Rd vehicle access (entry and exit gates and new sealed car park)
- retaining walls and noise barrier 250 m in length (subject to further approval)
- installing combined services route
- upgrading low voltage and short power supply for existing and new equipment.


February 2025 Works
In February works will include
Transport for NSW will continue carrying out construction activities in and around the station building on Argyle Street, Lackey Road and Dalys Way.
During this period we’ll be:
• installing a kiss and ride zone and pram ramp on Argyle St near the Clock Tower.
• footpath resurfacing works, near Leighton Gardens.
• reinstating temporary toilet in the station forecourt to carry out minor modifications to the male and female toilets.
• resurfacing pathways near forecourt.
• upgrading ticket window and installing new automated doors to the waiting room, luggage room and station office.
• continued work on stabling yard and foundation work for sound barrier on Lackey Rd.
• installing temporary concrete barriers along eastern side Lackey Rd and a 'no stopping' zone on the western time.
What will this mean for the Community
- Entry via front of the waiting room building.
- Pedestrian access to pathway along Argyle St near Leighton Gardens will be temporarily relocated to path through gardens while footpath is resurfaced.
- Traffic and pedestrian arrangements will remain in place along Dalys Way.
- More workers in and around the station buildings with some work zones.
- Bus and Taxi zones relocated further south on Argyle St until the end of February.
- Parking spaces may be adjusted to allow for work to continue safely. No change to accessible parking.
When and what time will works take place?
Work will be carried out during standard construction hours, 7.00 am to 6.00 pm Monday to Friday and 8.00 am to 1.00 pm Saturdays.
All work is dependent on weather and site conditions and is subject to change.
January 2025 Works
In January works will include
Transport for NSW will continue carrying out construction activities in and around the station and stabling yard, as well as on Argyle Street, Lackey Road and Dalys Way. Work will be scaled back over the Christmas period.
During this period we’ll be:
• starting work from the Argyle Street footpath to the footbridge, requiring minor road changes and an alternate marked walkway
• removing temporary amenities at the station forecourt. Work will restart in January in the male and female toilets
• making minor temporary adjustments to parking and space within the forecourt
• continuing work on the stabling yard
• installing the Lackey Road lift and platform lift from mid-January. There will be no additional impacts with all work contained to the existing work areas
What will this mean for the Community
- Revised location of Disability (DDA) parking in the commuter car park closest to the station.
- Reinstating some parking spaces.
- Relocation of the pedestrian access to Lackey Road side on Dalys Way, with a marked footpath and safety barriers.
- One-way vehicle access on Dalys Way with traffic control and boom gates/traffic lights.
- Access to waiting room via rear doors.
- Work commencing for female waiting room and male toilet in early January. Temporary facilities will be available.
When and what time will works take place?
Work will be carried out during standard construction hours, 7.00 am to 6.00 pm Monday to Friday and 8.00 am to 1.00 pm Saturdays.
All work is dependent on weather and site conditions and is subject to change.
December 2024 Works
In December works will include
A continuation of construction activities around the station building and on Argyle Street, Lackey Road and Dalys Way.
- work in the forecourt and station entrance including some excavation with archaeological supervision, plumbing and new kerb.
- work around the lifts at Argyle St entrance and the courtyard.
- finalising work on Accessible Toilet.
- continued work on compound at Lackey Rd railway footbridge for the new lift installation.
- continued track work at permanent stabling yard and retaining wall construction.
- work around mobile train simulator near Dalys Way.
What will this mean for the Community
- Lackey Road will be closed between Garrett Street and Parkes Road from 7.00 am to 6.00 pm on Thursday 5 December due to large vehicle movements and deliveries. Detour routes will be clearly marked and traffic control will be in place to assist residents and businesses.
- Vehicle access on Dalys Way will change to single lane, with traffic control and/or boom gates or traffic lights in place.
- Pedestrian access relocated to the opposite side of Dalys Way with a marked footpath and temporary safety barriers.
When and what time will works take place?
Most work will be carried out during extended construction hours, from 7am to 6pm Monday to Friday and 7am to 3pm Saturdays.
November 2024 Works
November works will include
Construction continues this month around the station building and on Argyle Street, Lackey Road and Daly's Way, including:
- excavation work including archaeological supervision, plumbing, new kerbs and gutters.
- scaffolding will go up around the lifts at the Argyle St entrance.
- works inside the station on the Family Accessible Toilet.
- work at Lackey Rd footbridge and stairs with excavation and concrete being poured.
- major excavation and partial removal of the track and existing amenities will begin in the permanent stabling yard. Including a 100,000L detention tank installation by medium sized crane.
- large vehicle movement with traffic control in place on Lackey Rd as needed.
- Up to 4 car spaces may be temporarily unavailable in the commuter car park on Dalys Way.
- Most works will be carried out during standard construction hours, 7.00 am - 6.00 pm Monday to Friday, and 8.00 am - 1.00 pm Saturdays.
Out of hours works
Out-of-hours work will be carried out between 6.00 am Saturday 23 November and 6.00 pm Sunday 24 November. For the safety of staff and passengers this will take place during a scheduled Sydney Trains trackwork period when no trains are running, and the station is closed. Replacement bus service will operate from Argyle Street near Leighton Gardens.
The out of hours works will include:
- asphalt resurfacing.
- installing tactile indicators on Platform 1.
- upgrading power and communications systems.
- painting the footbridge, repair and electrical work.
- civil works within the commuter car park on Dalys Way.
What will this mean for the Community?
Passengers will notice changes to access of the station and parking in the station forecourt with revised locations for accessible parking spaces to the left of the station building.
- vehicle access will change to one-way traffic on Dalys Way with manned traffic control and/or boom gates or traffic lights in place at the top of Dalys Way
- pedestrian access on Dalys Way will change to the opposite side of the road. A marked footpath with temporary safety barriers will be established
- some parking spaces will be reinstated in the station forecourt near the entrance
- access to the station waiting room will remain via the rear doors.
Alternate toilet facilities will be provided at the station forecourt. Please follow the signage provided for access
October 2024 Works
October works will include:
Construction continues around the station building and on Argyle St, Lackey Rd and Dalys Way, including:
- civil works within station forecourt with archaelogical supervision.
- modifying commuter access and parking: revised disability parking in station forecourt.
- civil work on Argyle St, installing steel for new ramp.
- installing lift glazing, brickwork and lift car in courtyard and Argyle St.
- civil work to excavate and install lift pit for Lackey Rd lift.
- upgrading family accessible toilet and entrance to ladies toilet
- disconnection of exisiting light fittings and fixtures.
- Most works will be carried out during standard construction hours, 7.00 am - 6.00 pm Monday to Friday, and 8.00 am - 1.00 pm Saturdays.
What will this mean for the community?
- access closed to pedestrians via Argyle St.
- Traffic control along Lackey Rd.
- Large vehicles in the area
- Customer access to station waiting rooms via rear door.
- alternative toilet facilities available within the station forecourt. Signage available.
September 2024 Works
September works will include:
- setting up a site compound near the Lackey Road footbridge ahead of lift installation
- establishing a new site compound further along Lackey Road opposite Parkes Road, including deliveries and some excavation to prepare for work at the stabling yard to begin.
- steel delivery and installation for the new lift and footbridge maintenance on Argyle Street
- dust containing small traces of lead and asbestos will continue to be removed from the station building ceilings at night by a licenced asbestos removalist, ensuring the safety of passengers and the community.
- opening the temporary stabling yard from Monday 9 September.
- Most work will take place during standard construction hours Monday to Friday 7am to 6pm and 8am to 1pm Saturdays
- Out-of-hours work will be carried out between 3am Saturday 14 September and 6pm Sunday 15 September during a scheduled Sydney Trains trackwork period when no trains are running and the station is closed. Some work during this time may generate higher than normal levels of noise. Noise assessments will be carried out and respite vouchers may be offered.
Work to be completed includes:
- establishing a temporary bus shelter in Leighton Gardens on Argyle Street for rail replacement buses
- installing structural steel for the new lifts in the station courtyard and on Argyle Street
- work on both the Argyle Street and Lackey Road footbridges
- removing trees on Dalys Way to make space for the new parking arrangement and road resurfacing
What will this mean for the community?
- A pick-up and drop-off zone will be available at the station entrance, except for the weekend of Saturday 14 September and Sunday 15 September, when buses are replacing trains. All buses will leave from Argyle Street near Leighton Gardens. During this time, there will also be no pedestrian access on Dalys Way or the Lackey Road footbridge. Traffic control will be in place to direct pedestrians and vehicles.
- Argyle Street car park will be closed from 3pm Friday 13 September until 6pm Sunday 15 September to allow for crane set up and steel deliveries. Traffic control will guide vehicles during this time.
- Traffic controllers on Lackey Road will direct traffic when the southbound lane is closed from Parkes Road towards Argyle Street/Illawarra Highway. There will be no detours and traffic will be bi-directional with reduced speed limits in place.
August 2024 Works
In August works will include:
- continuing excavation and concreting for the new lift installation at the Argyle Street entrance and in the courtyard
- excavating, trenching and services work in the existing work zone of the station forecourt
- establishing a new work area near the footbridge on Lackey Road for excavation and concreting ahead of lift installation
- retaining wall construction will continue in the temporary stabling yard area inside the rail corridor. Fencing, power and water services will be installed along with a temporary walkway for rail staff
- setting up site compound 3 on Lackey Road opposite Parkes Road will continue.
- All work will take place during standard construction hours Monday to Friday 7.00 am to 6.00 pm and 8.00 am to 1.00 pm Saturdays
What will this mean for the community?
- Access to the station waiting room will be through the rear doors.
- A pick-up and drop-off zone will be available at the station entrance.
- Traffic controllers on Lackey Road will direct traffic when the southbound lane is closed from Parkes Road towards Argyle Street/Illawarra Highway. There will be no detours and traffic will be bi-directional.
July 2024 Works
In July works will include:
- closure of the footbridge and ramp between Argyle Street and the station
- temporary hoarding at the station forecourt, courtyard and ticket office
- excavating work for new lift installation at the Argyle Street entrance
- vegetation removal and upgrade to the retaining wall on the station side of Lackey Road
- MTS work will continue near Dalys Way commuter car park
- deliveries and services to the temporary stabling yard will begin and site compound 3 will be set up on Lackey Road, opposite Parkes Road
- There will be traffic impacts on Lackey Road between Parkes Road and Argyle Street
- One-way traffic will be in place on a in a section of Lackey Road while vegetation removal and retaining wall work is ongoing for approximately 10 weeks
When: Traffic controls will be in place in the southbound lane during standard construction hours Monday to Friday 7am to 6pm and 8am to 1pm Saturdays
A traffic alert was issued Friday 7 June 2024 for this road closure and updated on Live Traffic for commuters
A list of planned upgrades and details of the planning process was provided on the Transport for NSW’s project page:
Moss Vale Station and Stabling Yard Upgrade | Transport for NSW
Share your Story
Degnan asked for the community to share their stories and memories of Moss Vale Station. If you'd like to take part and share a story see the below flyer for details.
(PDF, 86KB)
The page also includes a project status section which will include information on key milestones, including the Moss Vale Station and Stabling Yard Upgrade Determination Report finalised in April 2024. Here, you can also sign up to receive email updates on this project directly from Transport for NSW.
Construction company, Degnan, have been tasked with delivering the design and construction of the improvement works. More information can also be found on their website:
Moss Vale Station Upgrade | degnan.com.au
For more information, call Transport for NSW on 1800 684 490, or email projects@transport.nsw.gov.au/mossvale
